Parking Deck:
MCPS wants the lower level of the garage to be completed for the basketball home games, first game is on 12/5
Phase 2:

Continuing electrical and mechanical underground rough-ins in areas G & F
Installing CMU walls in area G
Finishing up grade beams in area G
Backfilling area G
Next week laying stone for the aux gym slab on grade in area G, pouring the slab soon after that
Installing waterproofing in area F

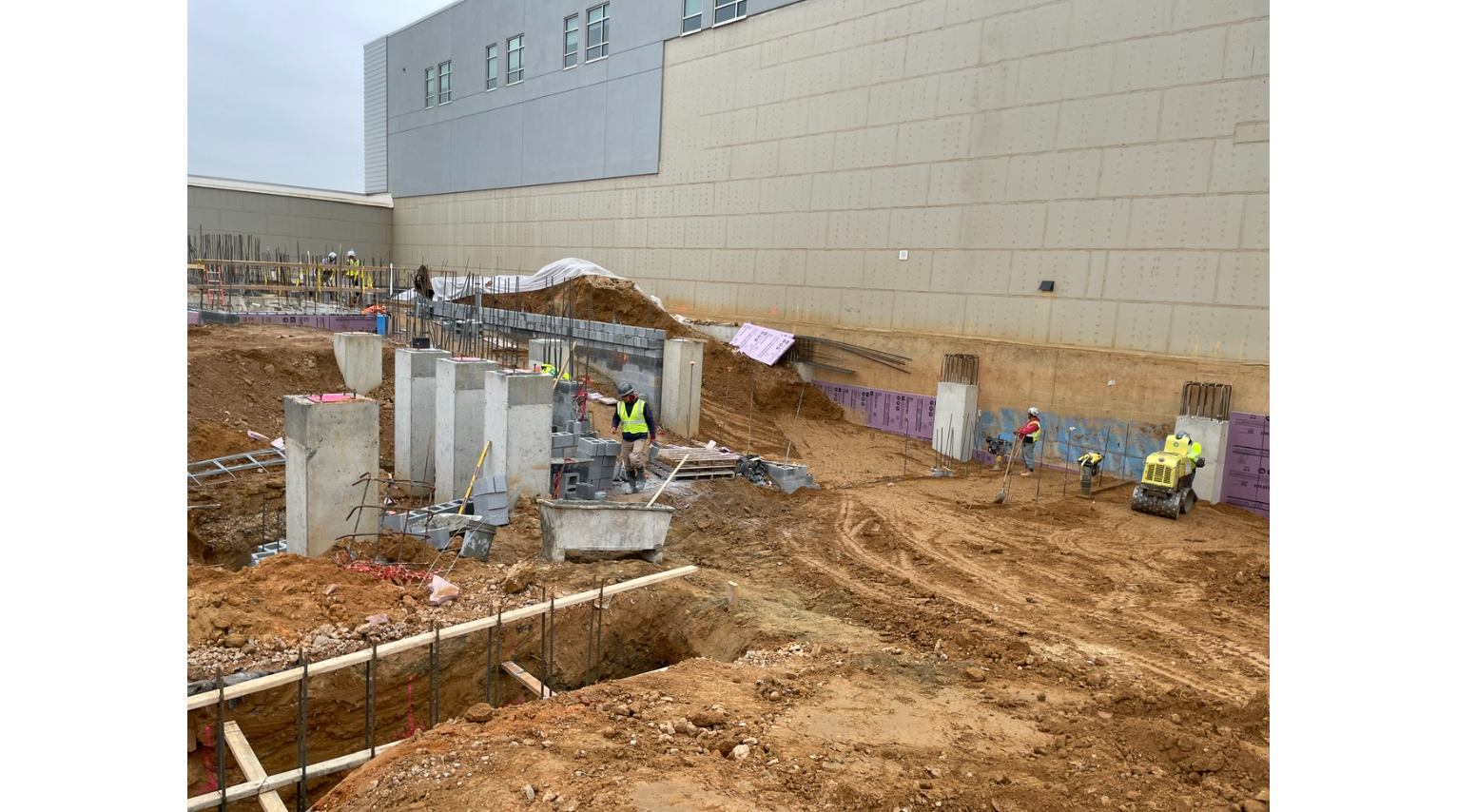

Backfilling area F
Continuing with concrete footings in area F
Continuing CMU walls in area F
Slab for orchestra pit in area F has been poured
Still waiting on SOE permit for the concession stand/wall 15/wall 11
Hess will be forwarding the permit information to Chris/MCPS

Wall 8 has been backfilled
Wall 10 is being backfilled currently
Continuing to build and backfill walls 12 and 9
Installing underground pipe at walls 12 and 9 and at the football stadium

Continuing to grade the football field
Installing sewer along the grandstand in two weeks
Hess will be contacting WSSC about the onsite pre-con
Visitor grandstand footings will be installed soon after underground lines have been completed
